ARTICLE

UKNZCBS in practice: Five lessons from real UK construction projects

The UK Net Zero Carbon Buildings Standard (UKNZCBS) sets mandatory, science-led limits on upfront carbon, operational energy, and life cycle performance. Meeting those limits requires changes to how projects are briefed, procured, managed on site, and evidenced at handover. Two case studies presented at the Carbon Experts Summit London in June 2026 provide some of the clearest early evidence on what works and what does not.

UKNZCBS in practice: Lessons from real construction projects | One Click LCA
10:02
UK Net Zero Carbon Building Standard (UKNZCBS) - practical lessons on implementation

UK Net Zero Carbon Building Standard (UKNZCBS) in practice:

Lesson 1: Set a carbon brief from day one

Kallum Desai, Global ScopeX Carbon Practice Lead at AECOM, described a net zero logistics site in England running from 2022 to 2026, delivered as a multi-disciplinary appointment from feasibility stage. The client set a clear target: a 50% whole life carbon reduction against their standard design approach.

"The carbon reduction target was in our brief from day one. That really helped drive this kind of change."

- Kallum Desai, Global ScopeX Carbon Practice Lead at AECOM

The project pre-dated the UKNZCBS, but when Version 1 published midway through delivery, it provided an aspirational framework. Against the standard's six core limits, the project is currently achieving four:

  • Upfront carbon at 635 kgCO2e/m2 GIA,
  • An on-site renewable energy upfront carbon limit of 1,000 kgCO2e/kWp,
  • A refrigerant GWP of 677 kgCO2e/kg,
  • Fossil fuel free status.

Operational energy intensity (target: 90 kWh/m2 GIA/year for conditioned storage) and on-site renewable electricity generation remain in progress, linked to the specific operational characteristics of a large logistics facility.

The lesson is direct: without a carbon target in the brief, the right conversations do not happen early enough to make a material difference to design decisions.

Carbon Designer 3D: Estimate embodied carbon by building type and size — visualise and compare the impacts of design alternatives

Early-design decarbonisation

Lesson 2: Early optimisation is where the savings are made

The ability to reduce whole life carbon is highest at RIBA Stages 0 to 2, and diminishes rapidly once spatial coordination and technical design lock in key structural and envelope decisions. On the AECOM logistics project, this meant whole life carbon optioneering from feasibility, evaluating reduced building height, optimised structural grids, hybrid timber frames, steel fibre reinforced concrete slabs, and low-carbon façade materials, all assessed alongside capital cost and life cycle cost implications.

Three options were developed:

  1. The client's standard design,
  2. A cost-neutral lower-carbon approach (which achieved a cost reduction through material efficiency),
  3. A full innovation scenario with novel materials at a cost premium.

This structured approach gave the client a transparent view of where carbon reductions were achievable without additional expenditure, and where innovation required investment.

The practical challenge, as Desai noted, is ensuring those designed savings are not lost during construction. Design-stage savings that cannot be verified at as-built represent a gap between ambition and performance that the UKNZCBS's verification process will expose.

AECOM presentation at Carbon Experts Summit London 2026

Life cycle costing: Identify the lowest-cost, lowest-carbon design option and maximise certification credits in one automated workflow.

Life cycle costing tool

Lesson 3: Embed net zero in procurement, not just design

Early carbon optioneering is necessary, but insufficient. AECOM's procurement approach combined four steps:

  1. A detailed sustainability questionnaire during the tender process that went beyond asking whether a contractor had a carbon management plan;
  2. Contractual obligations on specific low-carbon materials and methods;
  3. A pre-contract sustainability workshop to align contractor and design team on individual line-item requirements;
  4. Continuous carbon change management on site throughout delivery.

"There are synergies between designing out carbon and designing out cost, particularly with material efficiency measures. But translating that into procurement and built assets takes active management."

- Kallum Desai, Global ScopeX Carbon Practice Lead at AECOM

Contractual mechanisms such as NEC clause X29 allow low-carbon specifications to be formalised and enforceable. The AECOM team built a centralised net zero carbon spreadsheet listing every specification with its carbon value and a defined carbon limit per material, giving the contractor clear, verifiable commitments at the point of contract signing.

"Collaboration is required across the value chain, upstream and downstream, from clients through to material manufacturers, from designers to contractors. Everyone in this room has a role to play."

- Kallum Desai, Global ScopeX Carbon Practice Lead at AECOM

A guide for UK specifiers: How Environmental Product Declarations (EPDs) support UKNZCBS conformity.

Lesson 4: The data gap is at the as-built stage

Cailum Cherry, Senior Energy and Sustainability Consultant at Stantec, presented two projects assessed against the UKNZCBS: an 8,000 sqm new build office targeting NABERS 5-star Design for Performance, and a London retrofit of an established commercial building where more than 90% of the original facade was retained.

On the retrofit, the team tracked deliveries, waste, and transport throughout construction. Despite detailed upfront modelling, actual site waste emissions came in at 55 kgCO2e against a predicted 37 kgCO2e. Transport emissions, by contrast, were less than half the design estimate because the majority of deliveries originated within 50 km of the site — a finding that only became visible through granular site-level data collection.

"It really comes down to being prepared to challenge some of the predisposed ideas about how you're going to get there. If there's any disconnect between that data analysis and what's happening on site, you're going to struggle at the end."

- Cailum Cherry, Senior Energy and Sustainability Consultant at Stantec

The implication for UKNZCBS conformity is clear: as-built evidence is the standard. Design-stage modelling sets direction; site data determines the result.

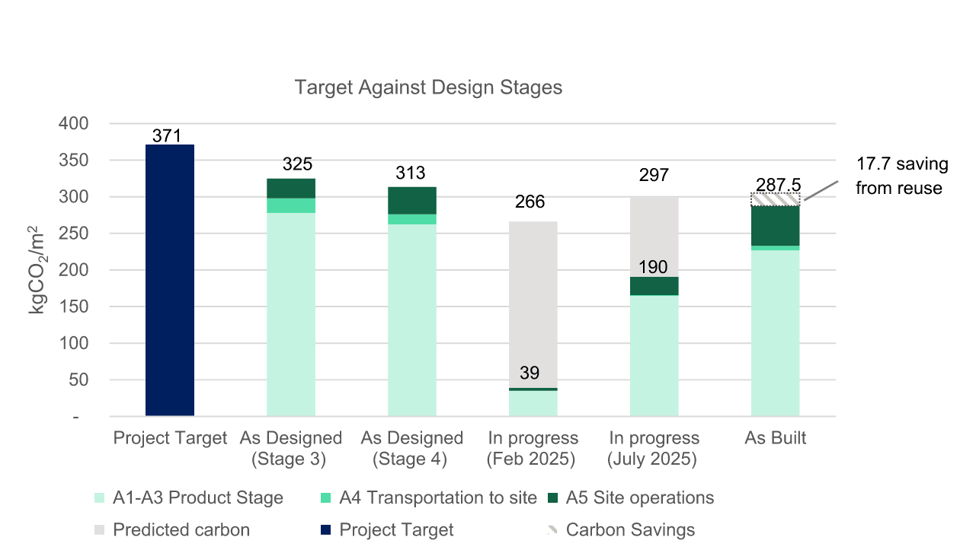

Stantec - Carbon Experts Summit London 2026

Lesson 5: Material reuse is the largest untapped lever

Before the London retrofit began, the Stantec team carried out a systematic reuse appraisal. The raised access floor was retained, saving 72 tonnes of CO2. Reusing 77 tonnes of paving slabs and rooftop plant concrete plinths delivered a further carbon saving of 7.9 tCO₂e (A1–A3)Around 90 tonnes of material were donated to charity, preventing an estimated 95 tonnes of CO2 and avoiding procurement costs.

"Reuse: we see this as a massive gap with the most upside."

- Cailum Cherry, Senior Energy and Sustainability Consultant at Stantec

The UKNZCBS requires life cycle embodied carbon to be reported, and future limit-tightening will increasingly reward circular approaches. Systematic reuse appraisal, conducted before strip-out begins and supported by robust life cycle assessment data, is one of the highest-return activities a project team can undertake, particularly on retrofit and refurbishment work.

Measure circularity: Optimise for circularity in construction, streamline material selection, design for disassembly, and end-of-life adaptability.

Building circularity tool

Supporting assessment from brief to as-built

Each of these lessons points to the same foundation: reliable whole life carbon data at every project stage. One Click LCA supports stage-by-stage assessment from feasibility optioneering through to as-built verification, aligned with RICS Whole Life Carbon Assessment v2 methodology, with access to 500,000+ datasets including Environmental Product Declaration (EPD) data. This provides the granularity that UKNZCBS verification will require and that well-managed construction programmes already demand.

FAQ

Q: When should whole life carbon optioneering begin on a UKNZCBS project?

Whole life carbon optioneering should begin at RIBA Stage 0 to 2, before structural and envelope decisions are fixed. The ability to reduce whole life carbon decreases sharply once technical design is underway. According to One Click LCA, AECOM's net zero logistics case study shows that early-stage optioneering delivered a cost-neutral lower-carbon design option alongside the client's standard approach.

Q: What is NEC clause X29, and how does it apply to UKNZCBS compliance?

NEC clause X29 is a contract mechanism that makes low-carbon specifications legally enforceable. It allows project teams to assign a defined carbon limit to individual material specifications at the point of contract signing, ensuring design-stage carbon commitments carry through procurement and on-site delivery. AECOM used this mechanism on a net zero logistics project in England to formalise material-level carbon obligations.

Q: What as-built data does UKNZCBS verification require?

UKNZCBS verification is based on as-built evidence, not design-stage modelling. Project teams must provide verified upfront carbon data reflecting materials actually installed, supported by records of quantities, transport distances, and construction activity. As Stantec's London retrofit case study showed, site waste and transport emissions regularly diverge from design predictions, making continuous site-level data collection essential to a successful verification submission.

Q: How much embodied carbon can material reuse save on a retrofit project?

Material reuse can deliver significant embodied carbon savings before a single new material is ordered. On a London commercial retrofit presented at the Carbon Experts Summit London in June 2026, Stantec saved 72 tonnes of CO2 by retaining the raised access floor and 79 tonnes from paving slab reuse. Donating 90 tonnes of material to charity avoided an estimated 95 tonnes of CO2.

Q: How does One Click LCA support UKNZCBS whole life carbon assessment?

One Click LCA supports RICS Whole Life Carbon Assessment v2-aligned assessments from feasibility optioneering through to as-built verification. The platform provides access to 500,000+ datasets including UK-specific Environmental Product Declaration (EPD) data, enabling project teams to track carbon performance at every RIBA stage and produce evidence in a format aligned with UKNZCBS verification requirements.

Q: What is the difference between upfront carbon and life cycle embodied carbon in the UKNZCBS?

Upfront carbon covers life cycle stages A1–A5: raw material extraction, manufacturing, transport to site, and construction. It is a mandatory limit under the UKNZCBS. Life cycle embodied carbon includes all stages from cradle to grave, including end of life. Under Version 1, life cycle embodied carbon is a reporting-only requirement with no pass or fail threshold, though limits are expected to tighten in future versions.
